A commercial fridge reaching its set point while empty is a starting condition, not an acceptance test for your service stock. Before relying on a newly installed cabinet—or a changed loading arrangement—agree what will be measured, what counts as an acceptable result and who will decide if the result falls short.
The useful question is specific: can this cabinet, in this position, support this loading and access pattern? A recovery time without those conditions is difficult to use. A cabinet reading also cannot settle whether food is safe: FSANZ advises checking actual food temperature rather than relying only on equipment gauges.
Set the acceptance criterion before starting the clock
Ask the supplier or commissioning technician to identify the applicable manual, the permitted loading arrangement and the recovery criterion for the proposed use. The food-safety lead should separately define the food checks and corrective actions. Record who agreed each part. If nobody can explain what would constitute a pass, leave acceptance open; a trace that eventually falls is not a substitute for an agreed criterion.
For cold potentially hazardous food, FSANZ's usual holding requirement is 5°C or colder, unless another safe temperature can be demonstrated. That is a food-control boundary. It is not a universal cabinet recovery deadline or a freezer set point. A test must not compromise your existing food-safety controls.
KW's proposed method below is an evidence record for that discussion, not a manufacturer test standard. Keep the equipment acceptance decision and the food disposition decision separate throughout.
First separate start-up from recovery
Check the exact instructions before treating a cold display as permission to load. As a document example, Bromic's January 2026 Version 3 upright display manual covers the UC0550GDL-NR, UC1250GDL-NR and UC1980GDL-NR refrigerators. Page 12 requires the refrigerator to run for at least 24 hours before loading, alongside instructions to preserve circulation and avoid overstocking. This is a preloading instruction for the named equipment—not a promise to recover from a load within 24 hours. See the exact Bromic manual, pages 11–12, and match the cabinet identity before using it.
For your cabinet, record completion of its installation and start-up prerequisites, the actual placement and the initial stable readings. Resolve any conflict between the model's specification and general manual wording with the supplier. Do not select whichever limit makes the proposed installation pass.
The climate-class evidence guide addresses rating interpretation. Here, the job is to record the conditions under which the acceptance observation occurs, not to award the cabinet a new rating.
Make the loading event reproducible
Agree a representative test load and access event with the supplier or commissioning technician. Record the quantity, container format, starting condition and shelf arrangement; do not substitute an arbitrary percentage of the cabinet's litre rating. If the proposed method uses a non-food load, have its suitability and limits agreed first. A water bottle or another substitute cannot, by itself, establish what every food product experiences.
Keep service stock under verified temperature control while the test is unresolved. Do not deliberately warm saleable food, defeat an alarm or change controller parameters to manufacture a useful-looking result. Electrical and refrigeration investigation belongs with the appropriate service specialist.
Use the following record alongside the agreed procedure. It captures what happened; it does not supply missing pass limits.
| Record | What makes it usable |
|---|---|
| Cabinet and conditions | Model, serial or asset ID, manual revision, location, ambient observation and completed start-up prerequisites. |
| Load and access | What was loaded, its starting condition and arrangement; when the agreed door event started and ended. |
| Measurements | Instrument identity and check status, measurement type and location, time-stamped readings, and any recorded defrost or other interruption. |
| Acceptance rule | Agreed target, observation window and stability requirement, their source, and the person responsible for assessment. |
| Result and action | Whether the agreed criterion was met, food-control actions where relevant, unresolved observations and the next responsible person. |
Keep cabinet and food readings labelled as different measurements. Where compatible monitoring is available, its records may help identify temperature changes and access events; check the supported functions in the manufacturer's monitoring documentation. Equipment data does not remove the need for the food checks appropriate to your operation.

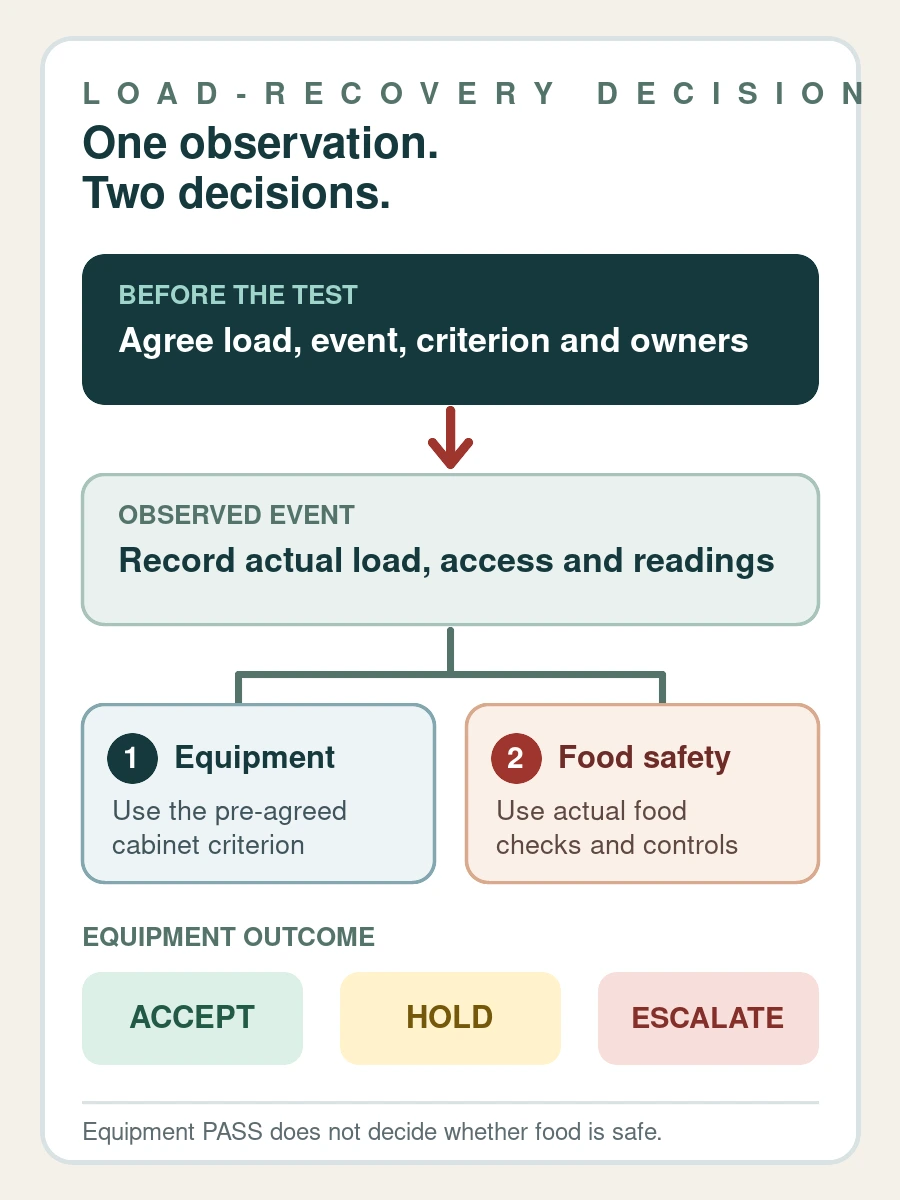

A falling trace can lead to three different decisions
Accept the documented use. The agreed equipment criterion was met, required food controls were maintained and the responsible people recorded their decisions. Keep the conditions with the result: acceptance applies to that documented arrangement and use. Do not generalise it to a larger load or a different service pattern.
Hold because the evidence is incomplete. The load, measuring point, starting condition or pass criterion is missing; an interruption makes the observation inconclusive; or only a cabinet display was checked when food evidence was needed. Identify the missing item and agree a controlled repeat. “It got cold eventually” does not repair an incomplete record.
Escalate because the agreed result was not achieved. Preserve the readings and conditions for the supplier or service technician. Describe the observation rather than diagnosing a compressor or refrigerant fault from the graph. Keep food under the operation's verified controls and apply its corrective-action procedure; do not wait for an equipment diagnosis to decide what to do with affected stock.
This distinction matters commercially. Missing evidence calls for a better observation. A failed, well-defined observation calls for investigation. Neither result, on its own, proves that you need a larger replacement cabinet.
Keep the conditions attached to the handover
Retain the agreed procedure, measurements, decision and permitted loading arrangement with the cabinet's operating record. Reassess when a change could take the cabinet outside that documented use—for example, relocation or a substantially different load or access pattern. The previous result remains a record of the previous conditions.
If the intended use is still being specified, take the load description and acceptance questions to the supplier when comparing commercial fridges and freezers. Ask for the exact-model manual and a clear response to the proposed use before committing to it. The useful handover is not simply “fridge checked”; it names what was checked, under which conditions, and who owns the next decision.
